Exhibition planning: the stages from idea to opening

How museum exhibition planning runs from proposal to opening day: the stages, who leads each one, when loans must start, and a working checklist.

Entry checked on

Measuring an empty room before any layout is drawn, while every option is still open.
Measuring an empty room before any layout is drawn, while every option is still open.

Exhibition planning is the work of turning an idea into an open gallery: setting objectives, writing a brief, choosing objects, securing loans, designing the space, producing and installing it, then checking whether it worked. Most museum teams move through the same sequence of stages whatever the size of the show; what changes is how long each stage takes and how many people share it. This guide sets out those stages, who usually leads each one, and the decisions that have to be settled early because everything after them depends on them.

What are the stages of exhibition planning?

Names vary between institutions, but the sequence is stable. A project starts as a proposal, becomes a concept with a written brief, moves through research and object selection, then through design and production, and ends with installation, opening and evaluation. The American Alliance of Museums reviews exhibitions against its Standards for Museum Exhibitions and Indicators of Excellence, which group criteria into seven categories: audience awareness, evaluation, content, collections, interpretation and communication, design and production, and human comfort, safety and accessibility (AAM). Those categories make a useful test for any plan, because each one needs an owner at a specific stage.

Stage Central question Typical output Usually led by
Proposal Why this exhibition, for whom, and why now? Short proposal approved by the director or programme committee Curator or programme lead
Concept and brief What must visitors take away? Exhibition brief with objectives, audience and constraints Curator, with interpretation and project management
Research and selection Which objects carry the argument? Object list, loan requests, rights list Curator and registrar
Design How will the space tell the story? Layout, then detailed drawings and specifications Exhibition designer
Production Can everything be written, built and mounted on time? Labels, graphics, cases, mounts, media Project manager with editors, fabricators and preparators
Installation and opening Is every object safe and every label right? Installed gallery, condition reports, final checks Registrar, preparators and conservator
Evaluation and close Did it work, and what do we keep? Evaluation findings, deinstall, archive of decisions Interpretation or evaluation lead

The table describes a common division of work, not a rule. In a small museum, two or three people may cover every column, and the stages still apply.

How do objectives become a plan the team can use?

Objectives are only useful when they can be checked. "Celebrate the town's textile history" is a theme; "visitors leave able to name two ways mill work changed family life" is an objective an evaluator can test. Write a short list, few enough that every member of the team can recite it, and phrase each one as something a visitor will know, feel or do.

The brief then turns objectives into constraints: audience, scope, budget range, schedule milestones and decision rights. Our guide to drafting an exhibition brief lists what that document should contain. Two habits keep objectives honest. First, test them with a few people from the intended audience before design starts, then again with draft labels and mock-ups, which is the logic of front-end, formative and summative evaluation. Second, write down how success will be judged after opening, so the final review compares results with intentions rather than with impressions.

Who curates and who runs the project?

Exhibition curation and project management are different jobs, even when one person holds both. The curator answers for the argument: the research, the choice of objects and the accuracy of every claim a label makes. The project manager answers for time, money and coordination: the schedule, the budget, the meeting rhythm and the record of decisions. When the two roles are merged without anyone saying so, either the schedule loses every argument with content, or content loses every argument with the schedule.

Around them sit the specialists whose constraints shape the plan: the registrar or collections manager for loans, insurance and object movement; the conservator for light, climate, handling and mounts; the designer; the interpretation or education lead; and the staff who will run the gallery once it opens. The Smithsonian Institution's Office of Policy and Analysis gave a whole study to these questions in October 2002, titled The Making of Exhibitions: Purpose, Structure, Roles and Process. Job titles matter less than decision rights, so write down who can approve a change to the objectives, the object list, the layout and the budget, and keep that list in the brief.

When do loans, indemnity and rights need to start?

Earlier than most first-time teams expect, because they depend on other institutions' calendars. Under the Spectrum standard published by Collections Trust, a borrowing museum needs a written agreement signed with the lender before any loan begins, insurance or indemnity cover for borrowed objects while they are its responsibility, including in transit, and up-to-date information on the location and condition of each object during the loan (Collections Trust). Each of those steps involves the lender's own approvals, couriers and condition checks.

Indemnity schemes add fixed dates. In the United States, the Arts and Artifacts Indemnity Program, created by Congress in 1975, is administered by the National Endowment for the Arts on behalf of the Federal Council on the Arts and the Humanities. It has two application deadlines a year for international exhibitions and two for domestic ones, and an application should not be submitted more than one year and three months before the indemnity period begins (NEA). In the United Kingdom, the Government Indemnity Scheme is an alternative to commercial insurance for objects lent to publicly accessible institutions; Arts Council England administers it with funding from the Department for Culture, Media and Sport, and the cover runs through transit, storage, set up, display and dismantling (GOV.UK).

Rights follow the same logic. Reproduction rights for images used in labels, a catalogue or online material belong in the selection stage, not in production. The guide to object selection criteria recommends confirming rights and care conditions while the list is still open, so that an object that cannot be shown safely or credited is dropped before anyone has promised it.

How does design move from concept to drawings?

Exhibition design usually advances in phases borrowed from architecture. A concept or schematic phase settles the visitor route, the zones and the rough position of key objects. A design development phase fixes cases, mounts, graphics, lighting and media. Final drawings and specifications then give fabricators something they can price and build. Each phase should end with a review against the brief and a dated freeze of what is no longer open.

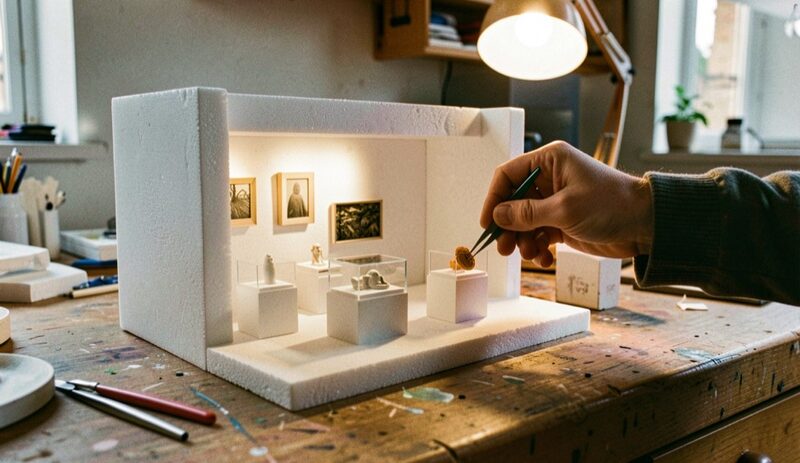

A white foam board scale model of a gallery on a workshop table, miniature plinths, display cases and framed pictures inside, a hand placing a tiny object with tweezers under a desk lamp
A scale model lets a team test sightlines and case positions long before anything is built.

Light and environment belong in the first phase, not the last. Sensitive materials can limit light levels, exposure time or the type of case, and those limits shape the layout itself. Accessibility follows the same rule: route widths, seating, label height and reading level cost little to plan on paper and a great deal to correct in a built gallery. Formative testing of draft labels and mock-ups fits inside design development, while changes are still cheap.

An exhibition planning checklist, stage by stage

A checklist does not replace the schedule. It tells the team which questions must be closed before the next stage begins.

  • Proposal: purpose, audience, fit with the museum's plan, rough budget range, target opening window.
  • Concept and brief: written objectives, key messages, scope, constraints, decision rights, evaluation plan.
  • Research and selection: working object list, loan requests sent, rights list started, care and light requirements recorded.
  • Loans and indemnity: agreements drafted, cover arranged, courier and transport requirements noted, indemnity deadlines entered in the calendar.
  • Design: layout approved, case and mount list, lighting plan, accessibility review, design freeze dated.
  • Production: label texts edited and checked against the objects, graphics proofed, mounts made, media tested on site.
  • Installation: condition reports on arrival, objects placed against the plan, labels matched to objects, security and environment checked.
  • Opening and after: summative evaluation, deinstall and return schedule, and an archive of the brief, the selection log and the evaluation notes.

Why do exhibition plans slip?

Most delays come from decisions left open too long rather than from difficult tasks. The same patterns recur. The object list keeps changing after design has started, so cases and graphics are redrawn. Loan requests go out late, and a lender's committee dates or courier availability end up setting the opening instead of the museum. Label writing starts only when design is finished, which leaves no time for editing, translation or testing. Nobody has clear authority to refuse an addition, so additions accumulate.

The remedy is unglamorous: a dated freeze for each list, a named person who approves changes, and a schedule built backwards from the opening date with external deadlines entered first. For an exhibition that travels, the same backwards logic applies to transit and installation windows at every venue.

Questions readers ask

How long does it take to plan a museum exhibition?

There is no single figure. A small display drawn from the museum's own collection can be planned in months, while a show built on loans depends on lenders' committees, couriers and, where an indemnity is used, application rounds that the US scheme holds only twice a year for each programme. Build the schedule backwards from opening and enter those external dates first.

What is the difference between exhibition curation and exhibition design?

Curation decides what the exhibition says and which objects support it. Design decides how visitors meet that argument in space, through layout, cases, light and graphics. The two meet in the brief, which gives both the same objectives and the same constraints.

What should an exhibition checklist include?

At minimum: objectives and audience, the object list with loan and rights status, care requirements, design freeze dates, label editing and checking, installation and condition reports, and an evaluation plan. The stage by stage list above can be copied into a spreadsheet and adapted to the size of the project.

Neighbouring entries

A team reviews visitor feedback notes pinned beside the exhibition plan during an evaluation session.

EPExhibitions

Exhibition evaluation basics for museum teams

A practical introduction to front-end, formative, and summative exhibition evaluation, with the questions each stage should answer before and after opening.

Draft labels meet the gallery wall as the editor tests what visitors will read.
